Average Amount of Overspending on Task Time
Average amount of overspending on task time is a key performance indicator that
shows how much on average you exceeded your schedule time or task duration (e.g.
in days). If deviation of planned duration for tasks is calculated by the
formula: Deviation of Planned Duration (Duration Variance) = Duration -

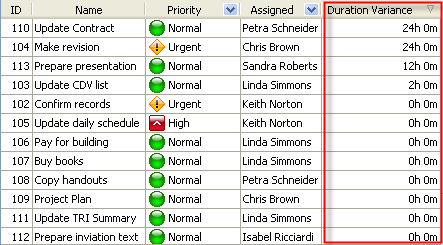

Baseline Duration, the KPI Average amount of overspending on
task time shows the average Duration Variance that has positive format.
This KPI
helps to define how successfully your planning was and estimate how much on
average you overspent on schedule in time for all active tasks.
If you need
to calculate the average amount of overspending
on task time, please do
the following:
- If
you need to view the average

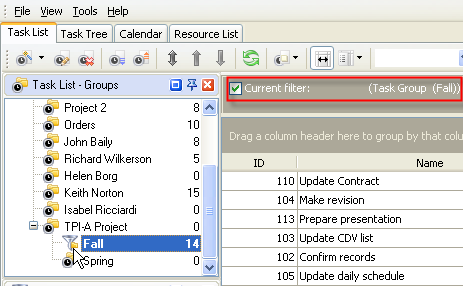

amount of overspending on task time per particular project on Task List, filter your to-do list by task
group with project tasks.
- To
display the average amount of overspending
on task time on Task List

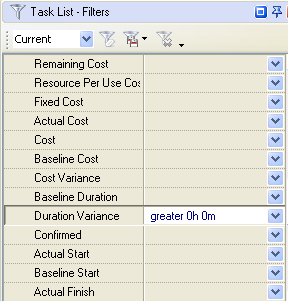

set filter by custom field "Duration Variance"

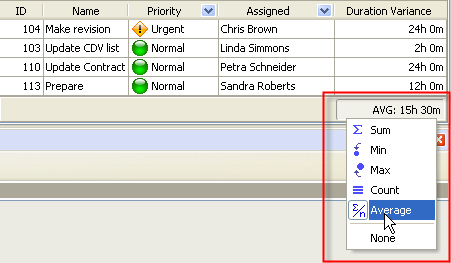

- Set footer:
- right click under column "Duration Variance"
- select "Average"
|
|
