Average overdue time of tasks is a key performance indicator that shows the average past due time (duration) within which the task
has been finally completed since its Due Date. Overdue time is calculated by the following formula:
Due Date – Closure Date
Due Date is the date by which the task should have been
completed.
Closure Date is the actual date of task accomplishment.
Depending on your needs this KPI helps to compare how
productive the resource was over some period of time.
If you need to count average overdue time of tasks, you
need to do the following:
1. Create custom field "Closure Date”:
- Go to: Tools/Custom fields and press "Ins” button

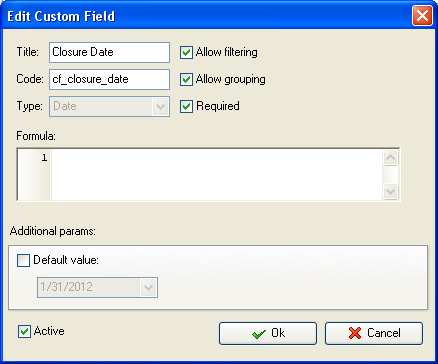

- In "Title” field enter "Closure Date”
- In "Code” field enter "cf_closure_date”
- In "Type” field select "Date” and click "Ok” button
2. Create custom field "Overdue Time”
- Go to: Tools/Custom fields and press "Ins” button
- In "Title” field enter "Overdue Time”
- In "Code” field enter "cf_overdue_time”
- In "Type” field select "Duration”

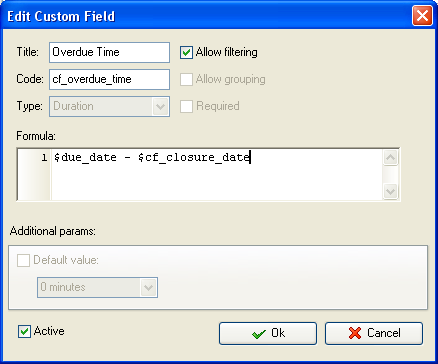

- In Formula field enter the formula below and click "Ok” button
$due_date - $cf_closure_date
3. If you need to view the average overdue time of tasks per

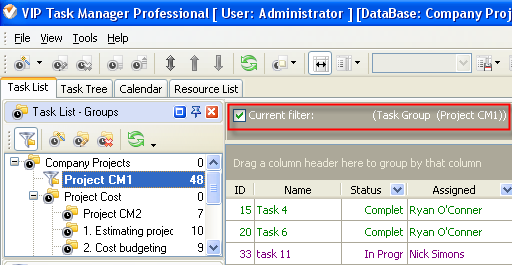

particular project, filter your to-do list by task group with project tasks.
4. Set filter by Status "Complete”. If you also need

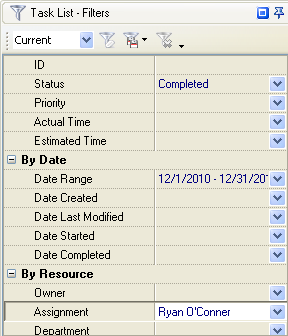

to view the average overdue time per assigned resource and some time span, set
appropriate filter on Task List – Filters panel.

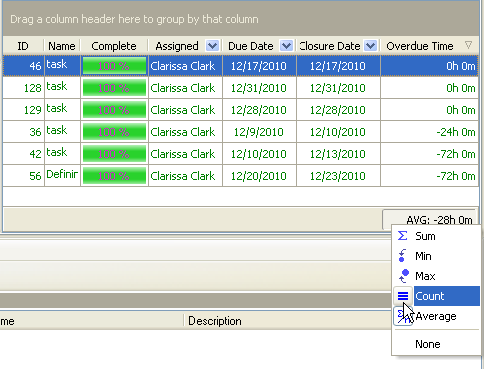

5. Set footer to
display the average overdue
time of tasks:
- - right click under column "Overdue Time”
- - select "Average”
If you need to view the average overdue time of tasks on
Task Tree, please follow the steps below:
- On

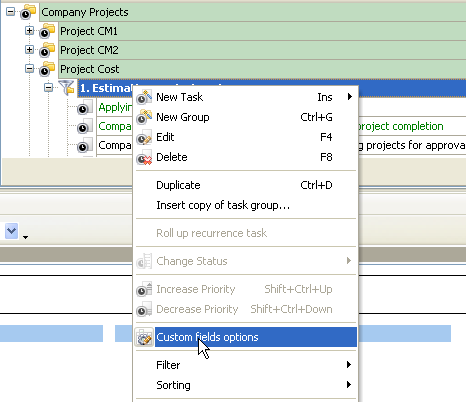

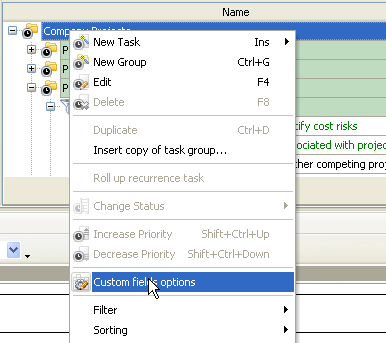

Task Tree select root task group and select "Custom fields options”
- To
enable the displaying of average overdue time select custom field "Overdue
time”, do the following:

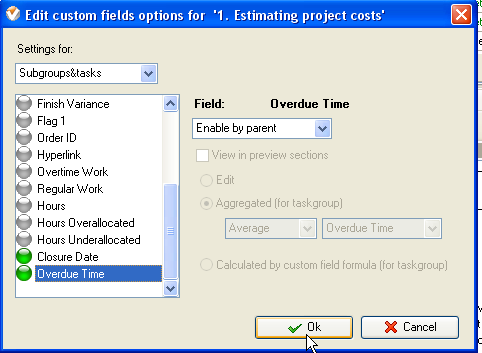

- - select Enable

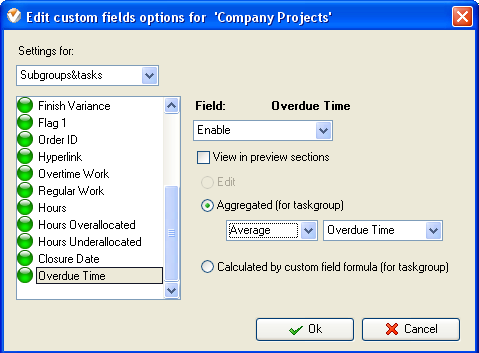

- - check "Aggregated (for task group)
- - select "Average” and the custom field name "Overdue
time”
- Select
task group for which you need to view the average overdue time, right
click and select "Custom fields options”
- Select
custom field "Overdue Time” and select the option "Enable by parent”.

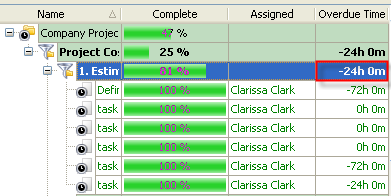

Overdue
time of tasks per project on Task Tree
