Average Schedule Completion Effectiveness

    The Average Schedule Completion Effectiveness (%) measures the number of scheduled hours (Baseline Work) to the number of actual hours needed to complete the task or project (Actual Work) expressed as the average percent rate. This KPI can be applied towards task or projects. If you count the Average Schedule Completion Effectiveness, you can determine or compare how successful your planning was within some time span.

    Schedule Completion Effectiveness (%) is calculated by the following formula:

    Baseline Work /Actual Work * 100

    To view the Average Schedule Completion Effectiveness, please do the following:

    1. Create custom field "Baseline Work":

    http://www.taskmanagementsoft.com/products/taskmanagerpro/tutorials/customization-guide/baseline-work.php

    2. Create custom field "Actual Work":

    http://www.taskmanagementsoft.com/products/taskmanagerpro/tutorials/customization-guide/actual-work.php

    3. Create custom field "% Schedule Completion Effectiveness":

  • Go to: Tools/Custom fields and press "Ins" button
  • In "Title" field enter "% Schedule Completion Effectiveness"
  • In "Code" field enter "cf_schedule_completion"
  • In"Type" field select "Integer"

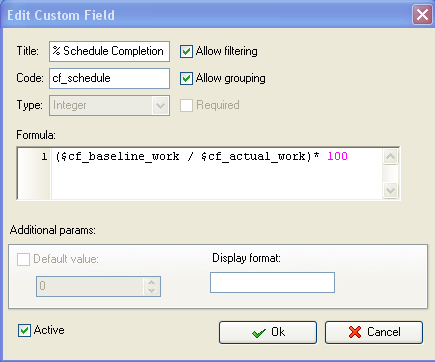

  • In Formula field enter the formula below and click "Ok" button
  • ($cf_baseline_work / $cf_actual_work)* 100
  • 4. to estimate the Average Schedule Completion Effectiveness per project double click on the required task group on Task List – Groups panel

    5. to view the Average Schedule Completion Effectiveness per resource and over some time span set the appropriate filters on Task List – Filters panel

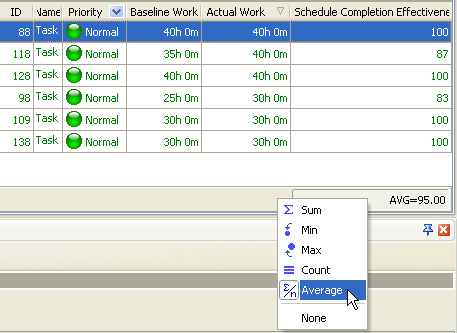

    6. Set footer to display the Average Schedule Completion Effectiveness:

    • right click under column "% Schedule Completion Effectiveness"
    • select "Average"

    To view the Average Schedule Completion Effectiveness per project do the following:

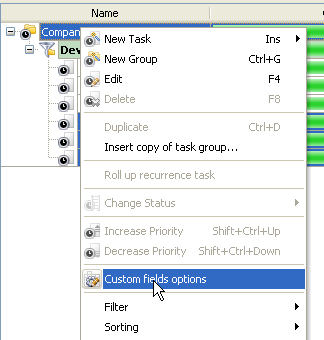

  • On Task Tree select root task group and select "Custom fields options"

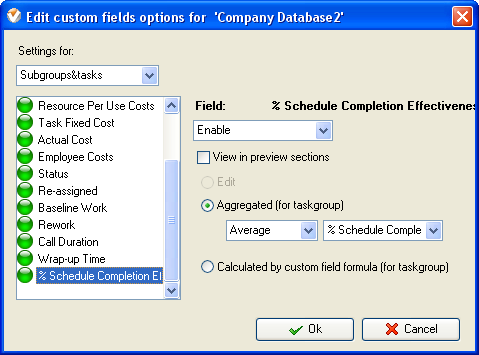

  • To enable the displaying of the Average Schedule Completion Effectiveness select custom field "% Schedule Completion Effectiveness" and do the following:
    • select Enable
    • check "Aggregated (for task group)
    • select "Average" and the custom field name "% Schedule Completion Effectiveness"

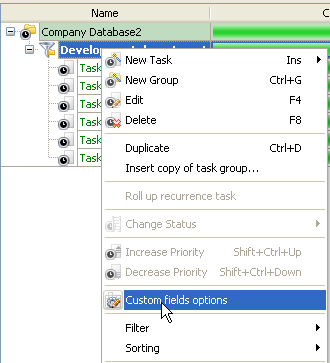

  • Select task group for which you need to view the Average Schedule Completion Effectiveness, right click and select "Custom fields options"

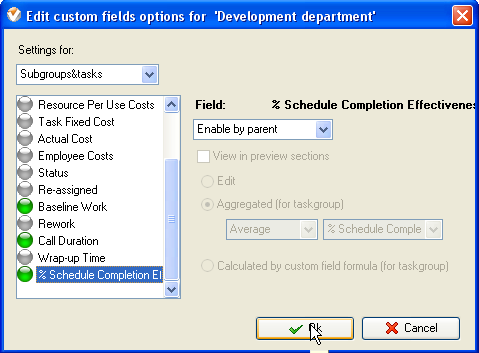

  • Select custom field "% Schedule Completion Effectiveness" and select the option "Enable by parent".

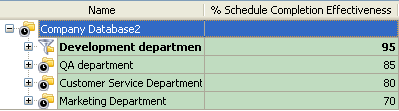

  •   Average Schedule Completion Effectiveness per project on Task Tree


Play demo Play Demo

TryTry It FREE
Overview VIP Task Manager

» VIP Task Manager Pro
   VIP Task Manager Std
   Testimonials
   Turnkey Solution




Login:
Password:
Forgot your password?
Login As:
Login As
You can log in if you are registered at one of these services:

ProductsSolutionsDownloadSupportPurchaseContactsForumVideoMy Account
Copyright © 2004 - 2024 Task Management Software



Site Map
